Please review the May 2026 public meeting open house materials and provide your feedback via email to Steve Gramm (steve.gramm@state.sd.us) by June 2, 2026.
Interstate 29

I-29 Corridor Study

The Interstate 29 Corridor in the northwest reaches of the Sioux City metropolitan area serves the state of South Dakota and its local communities. We have the opportunity through an I-29 Corridor Study to establish a long-term plan that both modernizes the corridor while maintaining its versatility.

Study Background

The Interstate 29 (I-29) Corridor Study covers Union County, South Dakota, and includes portions of the interstate, interchanges, and cross streets within the urban boundary for the communities of North Sioux City and Dakota Dunes.

Over 11 miles of I-29 is due for major rehabilitation or reconstruction in the 2030 to 2035 timeframe. Past studies have identified the need for potential interchange improvements at exit 1 (Dakota Dunes Boulevard), exit 2 (River Drive), and exit 4 (Northshore Drive).

A potential exit 5 interchange was added to the I-29 Corridor Study in response to recent flooding events near exit 4 in North Sioux City. A possible location for the exit 5 interchange is being evaluated to enhance resiliency and provide an alternative route during future flooding events.

An implementation schedule is needed for I-29 construction projects throughout the corridor. An initial public meeting was held in 2023 to gather public feedback on the corridor vision and exits.

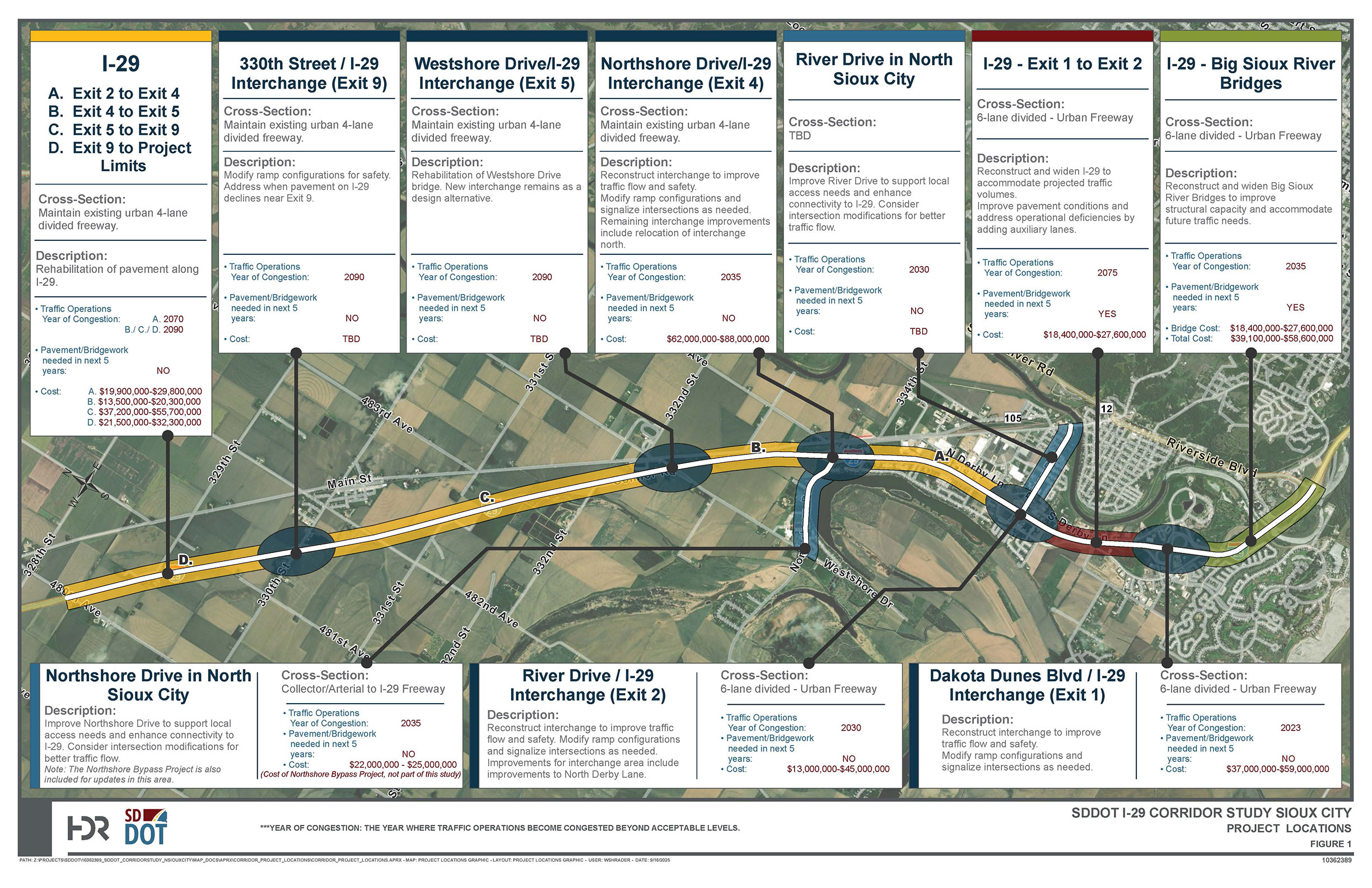

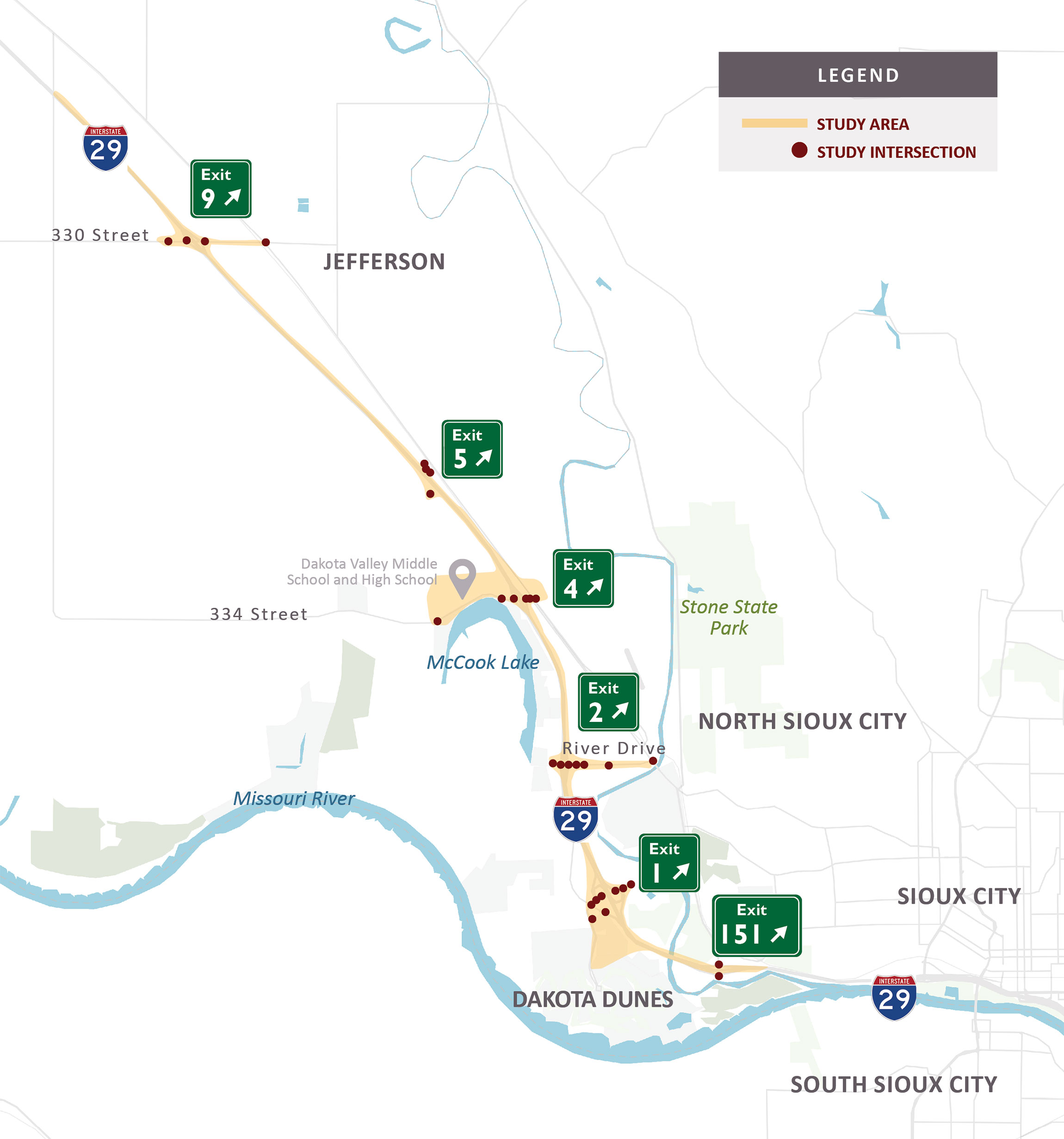

Interstate 29 Corridor Study Project Locations

Corridor Study map

I-29 between Exit 2 and 4, 4 and 5, 5 and 9, and 9 to the project limits

  • Cross-Section: Maintain existing urban 4-lane divided freeway
  • Description: Rehabilitation of pavement along I-29
  • Traffic Operations Year of Congestion: 2090, except for 2070 for exit 2 or 4
  • Pavement/Bridgework needed in next 5 years: No
  • Cost for between exit 2 and 4: Tier 2
  • Cost for between exit 4 and 5: Tier 1
  • Cost for between exit 5 and 9: Tier 3
  • Cost for between exit 9 and project limits: Tier 2

330th Street / I-29 Interchange (Exit 9)

  • Cross-Section: Maintain existing urban 4-lane divided freeway
  • Description: Modify ramp configurations for safety. Address when pavement on I-29 declines near Exit 9.
  • Traffic Operations Year of Congestion: 2090
  • Pavement/Bridgework needed in next 5 years: No
  • Cost: To be determined

Westshore Drive / I-29 Interchange (Exit 5)

  • Cross-Section: Maintain existing urban 4-lane divided freeway
  • Description: Rehabilitation of Westshore Drive bridge. New interchange remains as a design alternative.
  • Traffic Operations Year of Congestion: 2090
  • Pavement/Bridgework needed in next 5 years: No
  • Cost: Tier 4

Northshore Drive / I-29 Interchange (Exit 4)

  • Cross-Section: Maintain existing urban 4-lane divided freeway
  • Description: Reconstruct interchange to improve traffic flow and safety. Modify ramp configurations and signalize intersections as needed. Remaining interchange improvements include relocation of interchange north.
  • Traffic Operations Year of Congestion: 2035
  • Pavement/Bridgework needed in next 5 years: No
  • Cost: Tier 4

River Drive in North Sioux City

  • Cross-Section: To be determined
  • Description: Improve River Drive to support local access needs and enhance connectivity to I-29. Consider intersection modifications for better traffic flow.
  • Traffic Operations Year of Congestion: 2030
  • Pavement/Bridgework needed in next 5 years: No
  • Cost: To be determined

I-29 Exit 1 to Exit 2

  • Cross-Section: 6-lane divided - Urban Freeway
  • Description: Reconstruct and widen I-29 to accommodate projected traffic volumes. Improve pavement conditions and address operational deficiencies by adding auxiliary lanes.
  • Traffic Operations Year of Congestion: 2075
  • Pavement/Bridgework needed in next 5 years: Yes
  • Cost: Tier 1 to 2

I-29 - Big Sioux River Bridges

  • Cross-Section: 6-lane divided - Urban Freeway
  • Description: Reconstruct and widen Big Sioux River Bridges to improve structural capacity and accommodate future traffic needs.
  • Traffic Operations Year of Congestion: 2035
  • Pavement/Bridgework needed in next 5 years: Yes
  • Bridge Cost: Tier 2
  • Total Cost: Tier 3

Northshore Drive in North Sioux City

  • Cross-Section: Collector/Arterial to I-29 Freeway
  • Description: Improve Northshore Drive to support local access needs and enhance connectivity to I-29. Consider intersection modifications for better traffic flow. The Northshore Bypass Project is also included for updates in this area.
  • Traffic Operations Year of Congestion: 2035
  • Pavement/Bridgework needed in next 5 years: No
  • Cost: Tier 2 (not including Northshore Bypass Project)

River Drive / I-29 Interchange (Exit 2)

  • Cross-Section: 6-lane divided - Urban Freeway
  • Description: Reconstruct interchange to improve traffic flow and safety. Modify ramp configurations and signalize intersections as needed. Improvements for interchange area include improvements to North Derby Lane.
  • Traffic Operations Year of Congestion: 2030
  • Pavement/Bridgework needed in next 5 years: No
  • Cost: Tier 1 to 3

Dakota Dunes Boulevard / I-29 Interchange (Exit 1)

  • Cross-Section: 6-lane divided - Urban Freeway
  • Description: Reconstruct interchange to improve traffic flow and safety. Modify ramp configurations and signalize intersections as needed.
  • Traffic Operations Year of Congestion: 2023
  • Pavement/Bridgework needed in next 5 years: No
  • Cost: Tier 3
Projects shown represent anticipated future needs and potential improvements beyond the current Statewide Transportation Improvements Program programming horizon

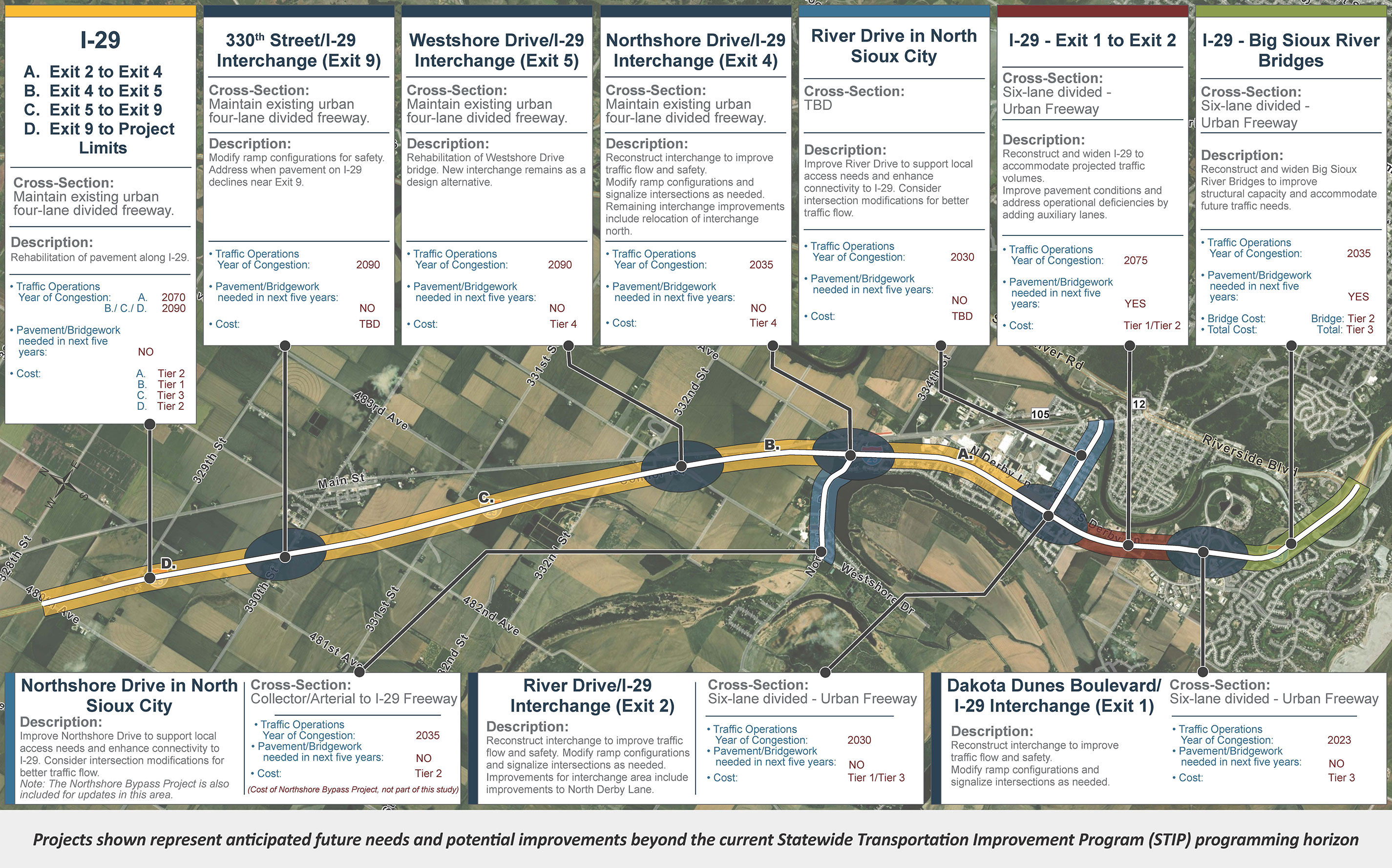

Interstate 29 Corridor Study Area

Corridor Study map showing project area along I-29 between Exit 9 and Exit 1

Study Objectives

The need for this study was identified by the Study Advisory Team (SAT), which is comprised of state, regional, local, and federal agencies, based on a number of factors. The SAT and project team have established the following objectives for the study:

Determine a future vision for I-29 mainline infrastructure

Determine potential interchange concepts that meet study advisory team objectives

Create an implementation schedule for I-29 construction projects throughout the corridor

Prepare partner agencies for future environmental study, permitting, and design

Schedule

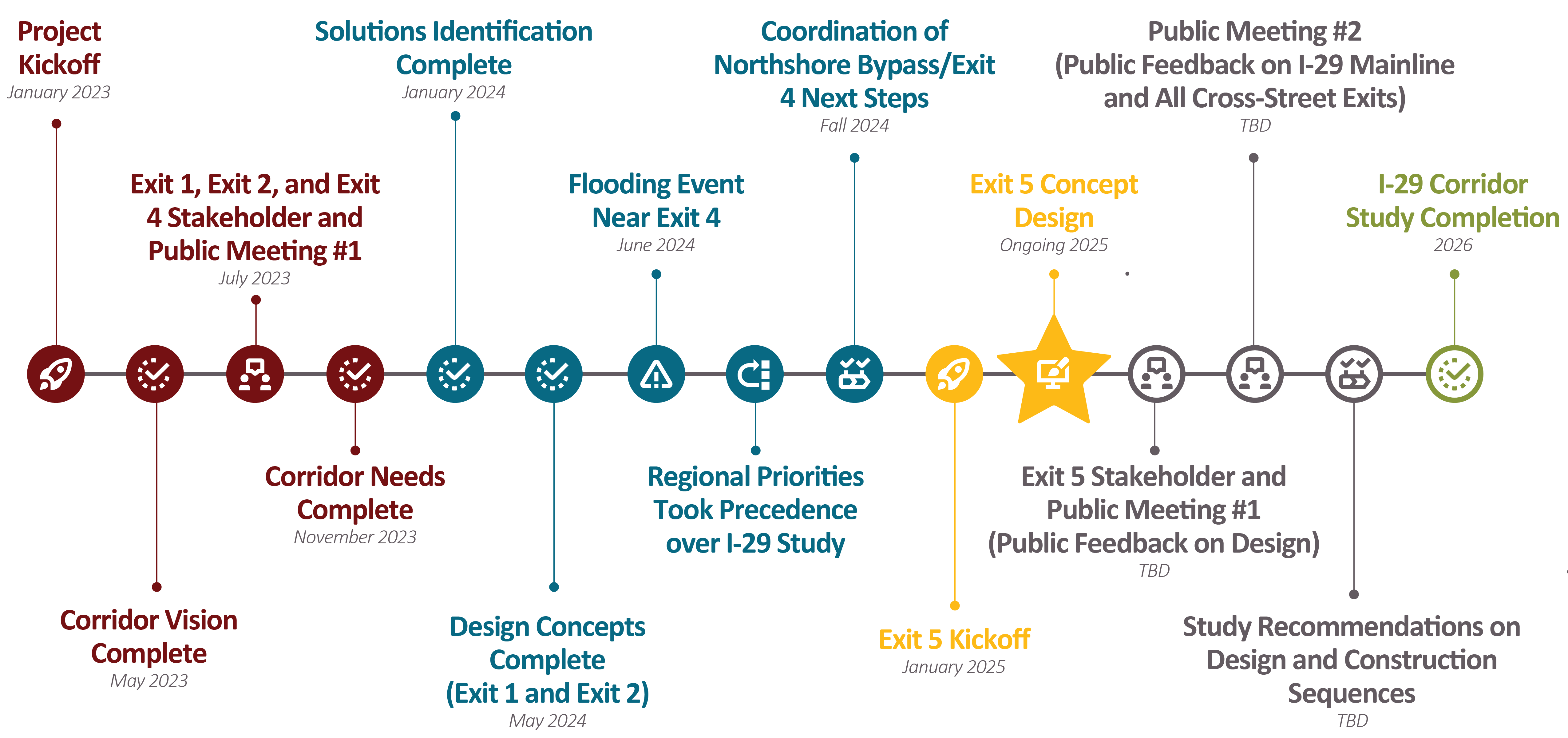

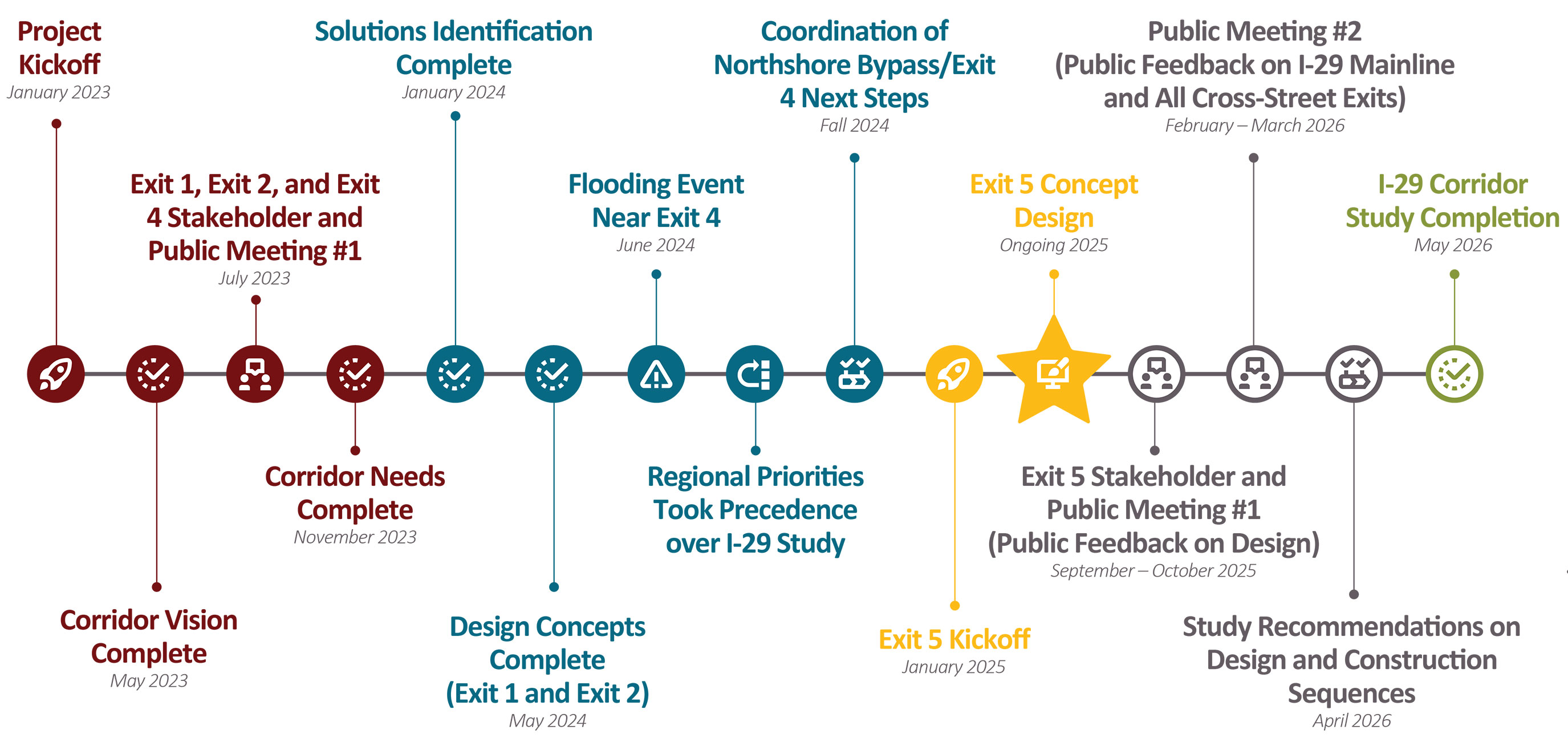

Project timeline.
  • Project Kickoff - January 2023
  • Corridor Vision Complete - May 2023
  • Stakeholder Meeting and Public Meeting #1 - July 2023
  • Corridor Needs Complete - November 2023
  • Solutions Identification Complete - January 2024
  • Design Concepts Complete (Exits 1 and 2) - May 2024
  • Flooding Event Near Exit 4 - June 2024
  • Regional Priorities Took Precedence over I-29 Study - Summer 2024
  • Coordination of Northshore Bypass/Exit 4 Next Steps - Fall 2024
  • Exit 5 Kickoff - January 2025
  • Stakeholder Meeting and Public Meeting #2 - October 2025
  • Exit 5 Design Concepts Complete - April 2026
  • Stakeholder Meeting and Public Meeting #3 - May 2026
  • Study Recommendations - Summer 2026
  • I-29 Corridor Study Completion - Fall 2026
